How to Search the Henderson County Court Docket
Start with the eCourts Portal, North Carolina's free public search tool. Its Smart Search opens a Case Summary, or Register of Actions. That covers Henderson County Superior Court, District Court, estates, and other public matters. A case number or citation number works best when you have one. No number? Try a party name, an attorney name or bar number, a business name, a cross-reference number, or even a nickname. Set the location to Henderson so statewide results stay tight on the county.
The portal is only one channel, though. The Clerk of Superior Court keeps the official Henderson County court docket. The same office holds the underlying case file. A public terminal at the clerk's office helps when a web result looks thin, when a record predates the portal, or when a file needs hands-on review. A brand-new filing may still be processing, and the portal never certifies a result. For anything official, the clerk's office has the last word.
- Open Portal and choose Smart Search for a Henderson County Case Summary.
- Enter the case number, citation number, or a focused name search and select the Henderson location filter.
- Match the result by case number, parties, assignment, and court location rather than by a familiar name alone.
- Use Search Hearings for a current setting, then compare it with the local calendar or court office when timing matters.
- Contact the Clerk for file inspection, a copy, or a certified record.
Note: Registering for My Cases lets you save cases you care about. It does not give a public user any deeper record access than anyone else.
Henderson County Portal Docket Search
North Carolina's portal training material spells out the difference between Smart Search and Search Hearings. Smart Search gives the fuller Henderson County court docket timeline; Search Hearings is the tool for an upcoming time and place. Henderson converted to Enterprise Justice, also called Odyssey, on July 22, 2024. That switch is why the old legacy county database no longer works as a search route.
The public view takes several search criteria, but a precise number is usually cleanest. For a partial name search, the state's wildcard instruction calls for at least three last-name characters plus an asterisk and at least one first-name character plus an asterisk. Case-number wildcards need four characters minimum before the asterisk.
| Portal field | Use in a Henderson County docket search | Notes |
|---|---|---|
| Search text | Case, citation, party, attorney, business, cross-reference, or nickname | Use one focused criterion first. |
| Location | Henderson judicial location | An optional filter that narrows statewide results. |
| Case type and status | Civil Actions, public Special Proceedings, Estates, or Criminal Actions | Advanced filters can reduce broad results. |
| Filing date range | Optional date filter | Use only when the approximate filing period is known. |
The Portal landing page is the state's public entry point for Henderson County court docket work.

The county courts page gathers the official channels a Portal result rests on. Those include court, schedule, payment, and contact links for Henderson County.
What a Henderson County Court Docket Shows
A Henderson County Case Summary pulls together the pieces a case makes public: identifiers, assignment, party information, chronological events, hearings, disposition, and financial information. Think of the Register of Actions as a timeline. It does not promise that every filed paper has a viewable image. A filing, motion, order, service event, hearing notice, continuance, judgment, or disposition can each appear as an event entry. Read the date and the full event text together before trusting a short label.
| Case number | Enterprise Justice uses year, case type, sequence, and county identifier, such as 21CR000003-440 when the current Henderson suffix applies. |
|---|---|
| Case and assignment | Shows case type, judicial location, and court assignment where public. |
| Parties and attorneys | Lists roles and listed counsel in public records, not an identity guarantee. |
| Events and documents | Records filings, motions, orders, notices, and other activity; public document availability can differ. |
| Hearings | Shows event history; use Search Hearings to confirm a current setting. |
| Disposition and financials | May show the case outcome and applicable public financial entries. |
Note: A dismissal, a continuance, and a judgment are three different events. The event date and any linked order tell you which one you are looking at.
Henderson County Docket Number Format
An Enterprise Justice case number has four parts. There is a two-digit year, a letter for case type, a six-digit sequence, and a three-digit county identifier. Current Henderson filings in District 42 carry the -440 county suffix. That suffix separates a Henderson County court docket result from a nearly identical number from elsewhere. It cannot replace reading the full case assignment, since older or migrated records may follow a different form.
When search results show similar names, the number beats the name every time. For eligible traffic cases, a citation number does the same job. Pull the number from a notice, citation, or court document. Run it through Smart Search, then run the same number through Search Hearings to check the live calendar.
- Case Summary
- Portal’s near-real-time public case view.
- Register of Actions
- The chronological portion of the Case Summary.
- Continuance
- A postponement; the earlier date remains historical while a later setting may replace it.
- Disposition
- The recorded result or status of a charge or case.
Which Henderson County Courts Keep Dockets
North Carolina runs one General Court of Justice, not separate county clerks for each trial court. Henderson sits in Superior Court District 42 and District Court District 42. One Clerk of Superior Court holds the records for both divisions, plus estates, special proceedings, judgments, and records that started with a magistrate. Magistrates are judicial officials. They do not run a separate county docket database.
| Court or office | Henderson County docket coverage | Where to search |
|---|---|---|
| Superior Court | Felonies, general civil matters, jury cases, and eligible appeals | Portal, then the Clerk for official file access. |
| District Court | Misdemeanors, infractions, traffic, family matters, lower civil matters, and small-claims appeals | Portal and Search Hearings, then Clerk or court office. |
| Clerk of Superior Court | Estates, special proceedings, judgments, public terminals, copies, and unified case files | Clerk counter and terminal at the Henderson courthouse. |
| Magistrates | Initial criminal process, small claims, and summary ejectment | Records route through the unified Clerk. |
The official courthouse page identifies the active county court location for both trial divisions.

For active court records, go to the Grove Street courthouse. The 1905 Historic Courthouse is not the record counter.
Henderson County Unified Clerk Dockets
The Henderson County Clerk of Superior Court keeps the official file behind the online docket. That one office handles Superior Court criminal and general-civil matters, District Court misdemeanor, infraction, traffic, and lower civil matters, plus estate and special-proceeding records. It is not the Register of Deeds and not a county public-information office. The unified route matters when a Portal entry is missing, a public terminal is needed, or an official copy is required.
G.S. 7A-109 requires the clerk to keep prescribed records, files, dockets, and indexes, and generally opens them to public inspection during regular office hours unless another law limits access. A browser printout is still not a certified record.
Finding Henderson County Court Dates
A docket event can preserve an old hearing even after the setting changes. For a current Henderson County court date, use the Portal's Search Hearings tool with a case number, party, business, attorney, judicial officer, or courtroom. The live result should show the current time and place. Smart Search covers history. The Henderson local administrative schedules lay out District 42 session structure and calendar links.
When the date truly matters, compare the live hearing result against any entered continuance or notice. Then call the right office. Superior Court Judges take calls at (828) 694-4230. District Court Judges take calls at (828) 694-4225, and the Clerk at (828) 694-4100. The detailed Henderson County court calendar page walks through the confirmation chain.
Henderson County Docket Setting Checks
A District 42 quarterly schedule sets the frame for Henderson County court dates. It answers little on its own. Labels like Cr, Fam, Juv, and CVD only tell you which calendar a matter sits on. They say nothing about the outcome. A session calendar lists the matters expected, yet it cannot promise each one will be reached. For a live setting check, Search Hearings is the tool that shows current court dates. Two entries can conflict. A notice of hearing or a call to the court office settles it.
Civil settings work under a local rule worth knowing. Under the District 42 Case Management Plan, the Senior Resident Superior Court Judge controls a civil trial calendar once it is set. Continuing a case takes a written AOC-CV-221 request. It must be filed at least 10 calendar days before the session, with a proposed new date attached. The old setting stays in the docket history even after a continuance. The Henderson court contact directory lists the court and clerk confirmation lines. You can reach the right office the first time.

Henderson County is large enough that a precise case number beats a broad name search. A common local surname alone can bury the docket entry you need.
Public Access to Henderson County Court Dockets
Henderson County court docket access runs through court-record rules, not a general county records request. Portal shows public Case Summary information. The Clerk handles the rest: in-person inspection, public terminals, copies, and certification. Some limits still apply. Juvenile files stay closed to ordinary public inspection. Unreturned warrants and protected personal or location details can be withheld, and an expunged or sealed matter may simply not appear in a public result.
Key North Carolina record rules:
G.S. 7A-109 makes the Clerk’s prescribed dockets, files, and indexes generally open to public inspection unless law limits access.
G.S. 7A-308 authorizes clerk copy, seal, exemplification, and certified criminal-search fees.
G.S. 7B-3000 restricts ordinary public access to juvenile records.
G.S. 15A-145 describes one specified expunction route and its conditions.
Note: A missing Portal result is not proof that no case exists. It can reflect a restriction, a processing delay, an older record, or a search mismatch.
Henderson County Portal Record Limits
Portal is a convenience view of the Henderson County court docket. It is not the official court record. Its public Case Summary can run near real time. Still, brand-new filings may sit in processing, and confidential material never shows. The Documents area carries only public material and may charge fees. Social Security numbers do not appear. A lawyer's elevated access is separate from ordinary registration. The state's AOC-A-264 process runs through File & Serve for authorized counsel.
Need a document, a recent filing, or an official result? The Clerk's public terminal or counter is the answer. The state's court-records guidance is plain. The file is viewed at the clerk office in the county where the case is located. That is the practical fallback for a Henderson County court docket search, not a failure of it.
The Henderson County Clerk and Docket Records
The Clerk of Superior Court keeps Henderson's docket records. The office also runs the counter where they live. Portal can locate public case information. The clerk verifies availability, maintains the county file, provides public-terminal access, and issues official copies. Bring the case number. Know whether you want a plain copy, a certified copy, or a specific document. For older files, page counts, restrictions, or document questions, call first.
Henderson County Clerk of Superior Court
200 N. Grove St., Suite 163
Hendersonville, NC 28792
(828) 694-4100
Copy fees follow a statutory formula. The first page of each document costs $2. Each additional page or fraction costs $0.25. A certificate under seal is $3, and an exemplification runs $10. A certified single-county criminal record search on AOC-CR-314 costs $25. The Clerk can confirm which fee applies and whether a document is public.
Henderson County Docket Access Changes

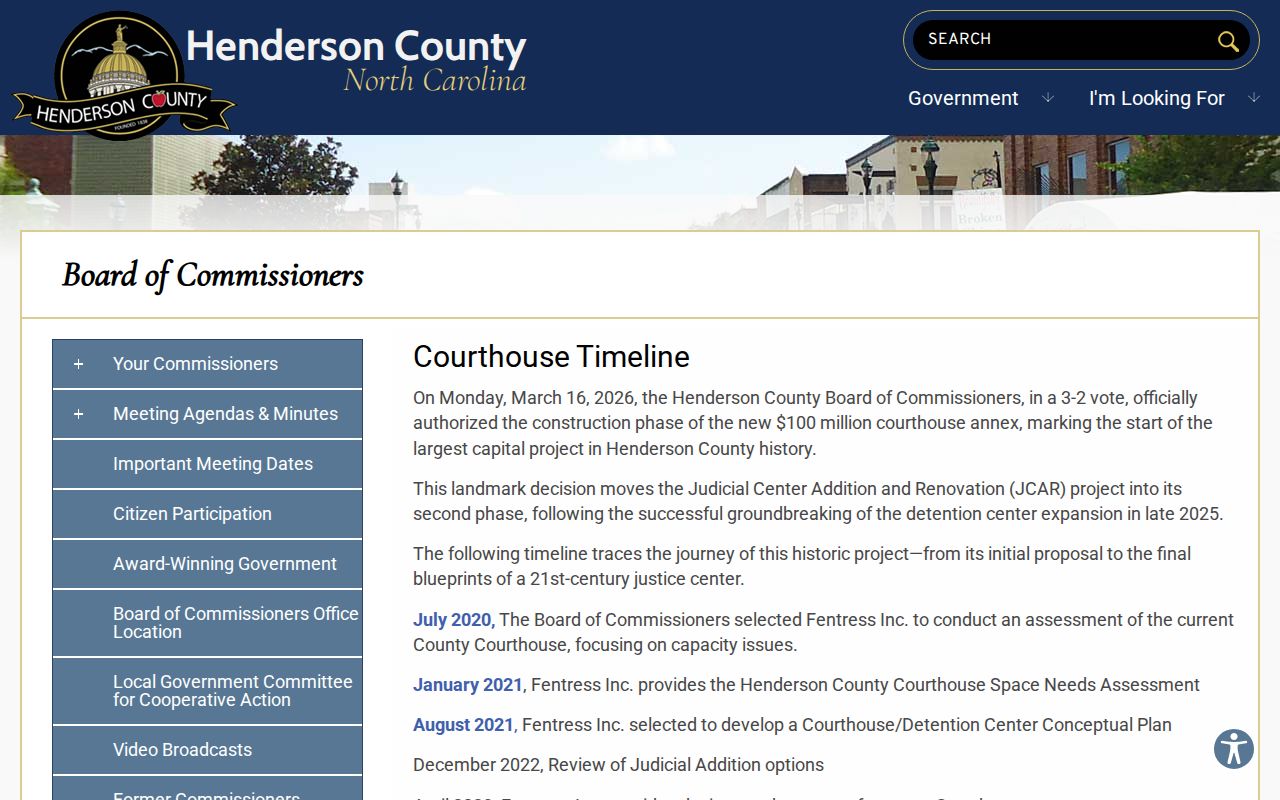

Court access in Henderson County shifted fast. A 2021 courthouse assessment flagged too few public computers and technology still built for paper. The bigger change came on July 22, 2024, when the county joined eCourts Track 5. Portal, Enterprise Justice, and File & Serve replaced the legacy systems. The Track 5 announcement lays out the migration. It also covers the temporary inquiry-only period on the old system.
Going digital has limits, though. Not every historic document made it online. Construction adds its own wrinkles. Work continues on the Judicial Center Addition and Renovation project. Before a records visit, check the county's current JCAR update. Entrance and parking arrangements can change with the work.
The courthouse timeline traces the full construction history that sits behind these ongoing access changes.

Construction is a practical reason to build extra time into a Clerk visit. Check live parking information before you go. The county project chronology traces the planning milestones that led to the current work.

The timeline places the current records-access adjustments in the county’s larger courthouse expansion plan.
Henderson County Docket Workload Context
The county's 2021 courthouse assessment offers historic scale. It is not a current tally of people or pending cases. Its 2019 planning table listed 22,899 criminal cases and 3,031 civil cases. The same table counted 1,100 estates and 953 special proceedings. The same assessment described public intake queues and too few terminals. Those numbers point to one strategy. Search the Henderson County court docket online first. Then make a focused Clerk visit when the record demands more than a quick Case Summary.

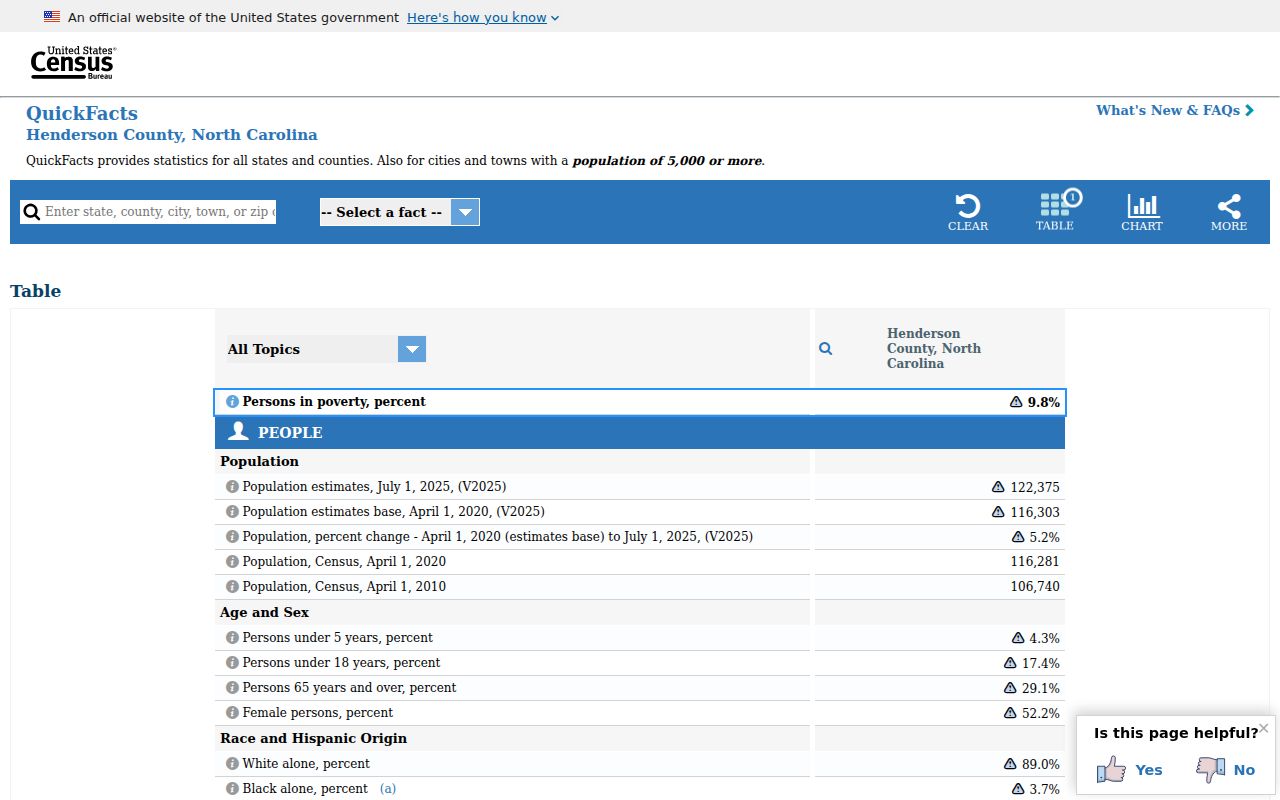

Census QuickFacts provides broader county population context.

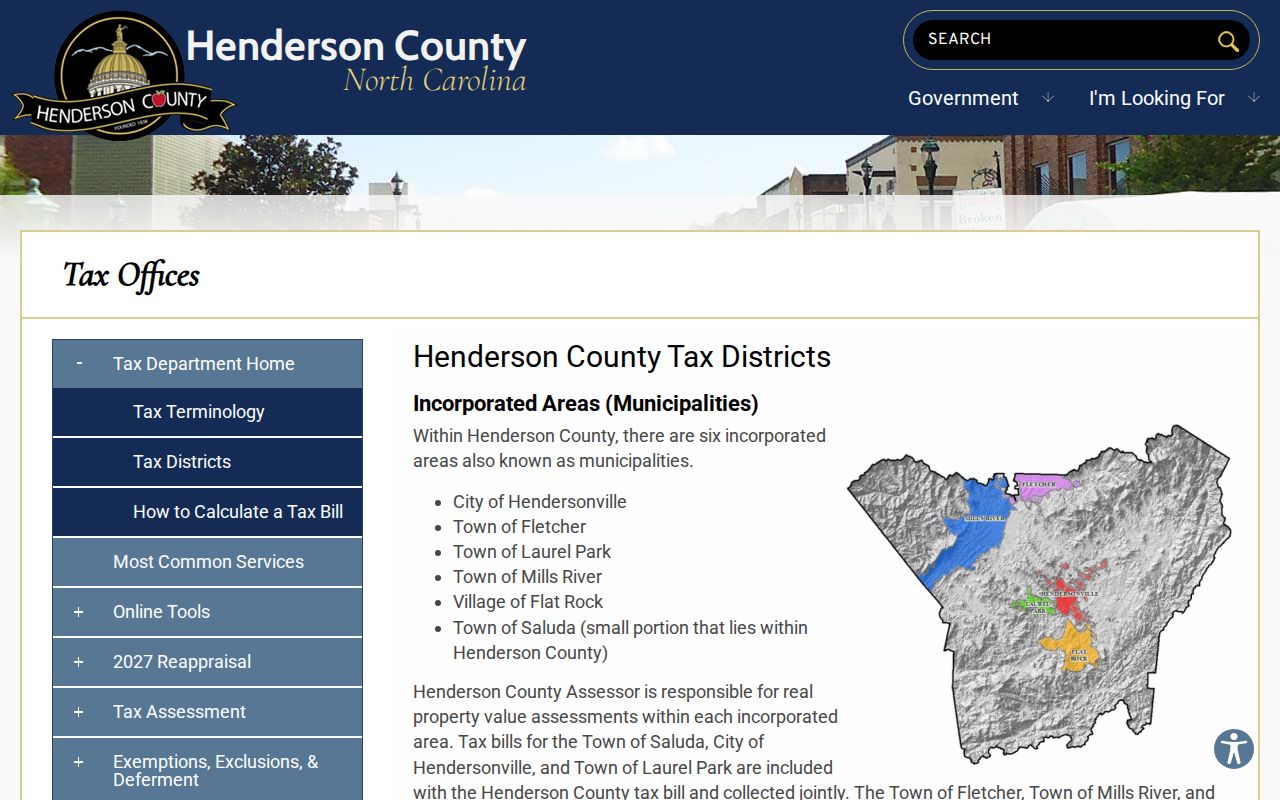

The county’s tax-district map helps distinguish five principal municipalities from separate court jurisdictions.
Henderson County Federal Docket Route
State-court records in Portal are separate from federal records. A Henderson County matter filed in the U.S. District Court for the Western District of North Carolina, usually the Asheville Division, belongs to the federal system. CM/ECF handles federal filing and case management. PACER supplies public docket and document access. Appeals from the Western District go to the Fourth Circuit, not the North Carolina Court of Appeals. PACER's pricing page explains the federal charge structure and the quarterly waiver, and the PACER Case Locator supports nationwide federal case-location searches.

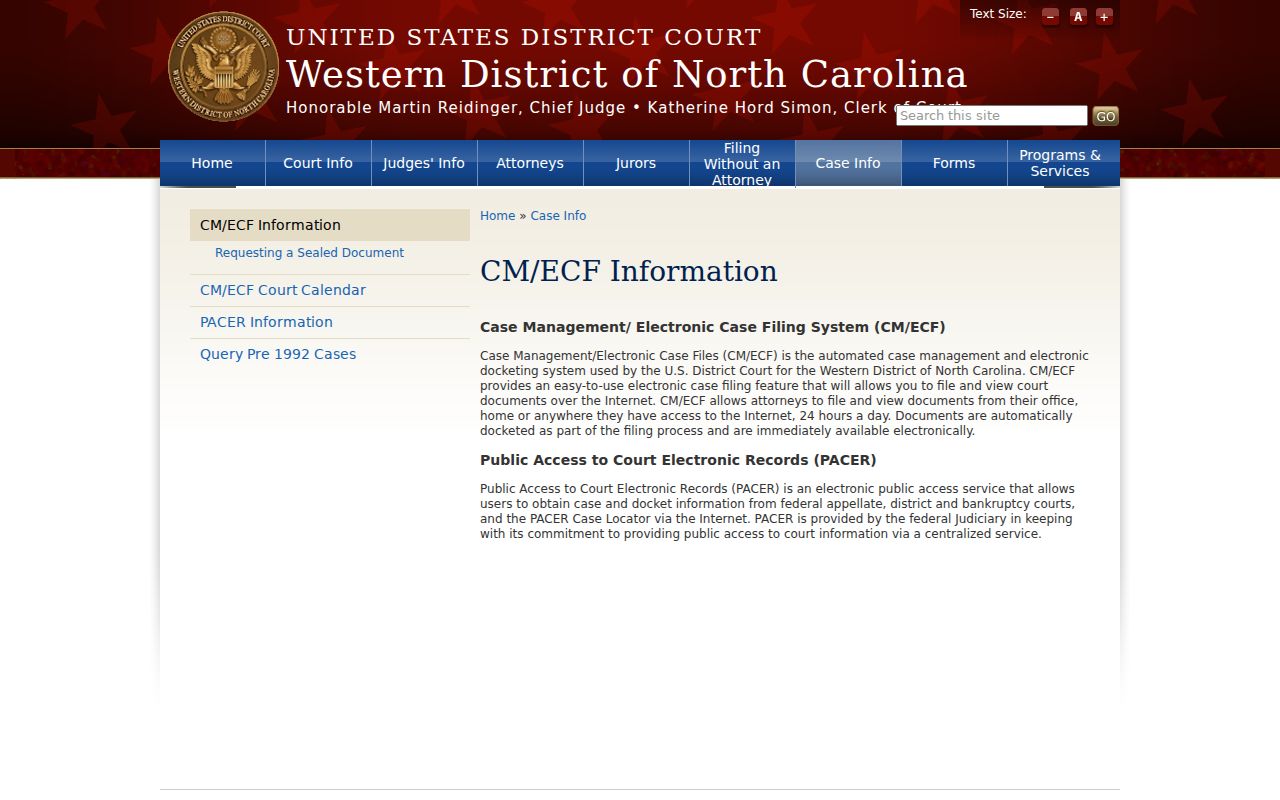

Federal fee rules govern PACER access and never replace North Carolina Clerk copy procedures. Western District CM/ECF information identifies the federal filing system behind that separate docket route.

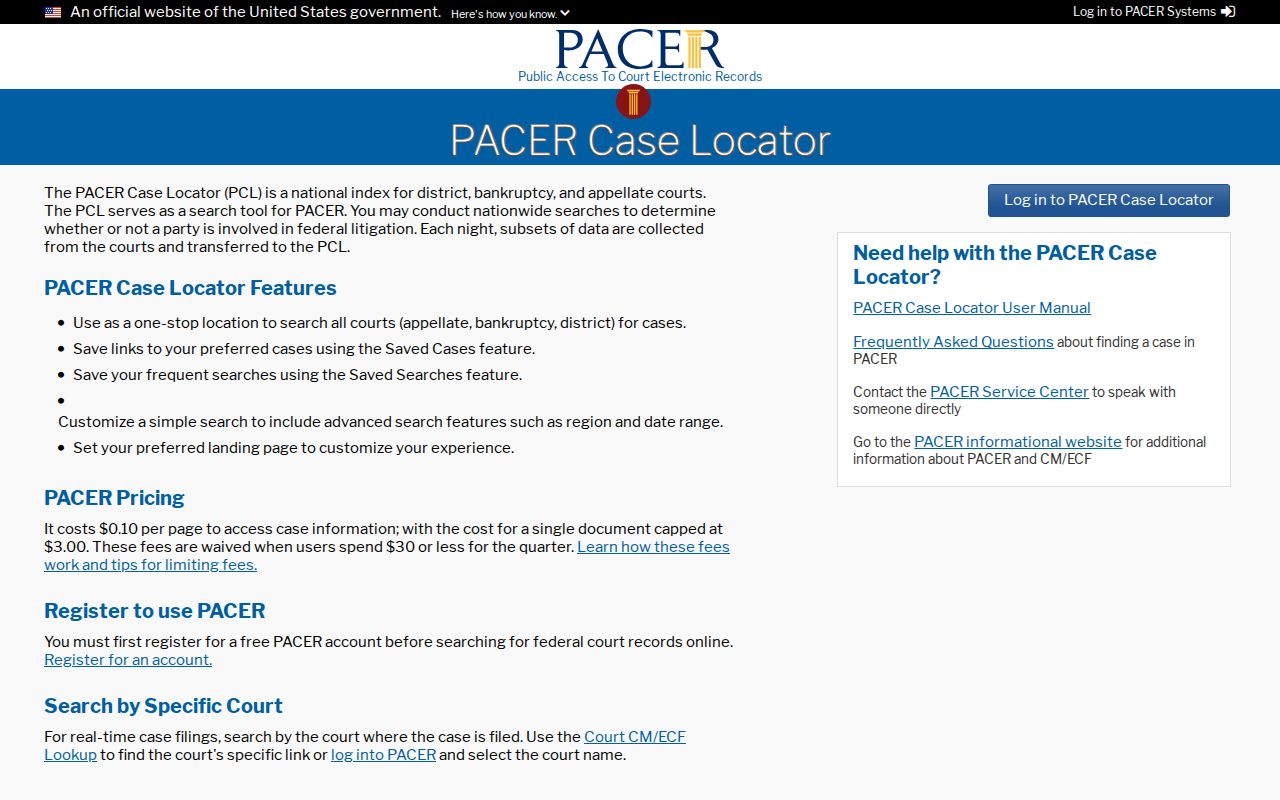

State cases run through the Portal and the Henderson Clerk, while federal files live in CM/ECF and PACER. The PACER Case Locator is the nationwide federal search layer.

That federal locator only helps when a case sits in federal court rather than in Henderson County's state courts. Most county matters never leave the state system.
Court Dockets by City in Henderson County
Five incorporated cities dot Henderson County: Hendersonville, Fletcher, Mills River, Flat Rock, and Laurel Park. Not one runs its own municipal court docket. A criminal matter or state-law citation from any of them lands in Henderson County District Court. The Clerk and Portal serve as the lookup points. Hendersonville alone keeps a separate administrative portal for parking citations. That portal is not a state traffic court record.
Hendersonville Court Docket
15,137 in the 2020 Census. State cases use District Court; city parking citations have a separate administrative route.
Fletcher Court Docket
7,987 in the 2020 Census. Fletcher police citations route directly to Henderson District Court.
Mills River Court Docket
7,078 in the 2020 Census. Sheriff-provided law enforcement does not create a town court docket.
Flat Rock Court Docket
3,486 in the 2020 Census. Village administrative hearings are distinct from state court cases.
Laurel Park Court Docket
2,250 in the 2020 Census. Local police citations use the county District Court route.
Map and Directions to the Henderson County Courthouse
Superior Court District 42 and District Court District 42 files are kept at the Henderson County Courthouse, 200 N. Grove St., Suite 163, in Hendersonville. The building, which opened in April 1995, holds one District criminal courtroom, one Superior criminal courtroom, two civil jury courtrooms, and a small-claims room. This is a different location from the county's Historic Courthouse at 1 Historic Courthouse Square, which is not the routine court-record counter.
Henderson County Courthouse
200 N. Grove St., Suite 163
Hendersonville, NC 28792
(828) 694-4100
Monday through Friday, 8:30 a.m. to 5:00 p.m.
A 2021 space-needs study found the clerk's intake area constrained, with limited queue space and public computers, so arriving with a case number helps. The county is also carrying out construction/parking work near the courthouse; check the county's parking/entrance page and call the construction/parking line, (828) 218-4155, for current changes and allow time for screening before a hearing.
